Around 15% of builders are using Pull Planning (although only 9% are using the full Last
Planner® System) on at least some of their projects, according to the AGC and McGraw
Hill [1] . The challenge is how to get the most value in the shortest time during a pull
planning session.
The authors of this blog have led and coached over 200 pull planning sessions in the last
few years, co-authored a book on the subject, and led dozens of training sessions and
webinars. We’ve seen it done right, done wrong, and learned from our mistakes and those
of others. We’ve refined the leadership needs for pull planning and can say with
confidence that leading a pull planning session takes “PEN”:
- Preparation
- Enthusiasm
- Neutrality
Of course, you need to know construction, the concept of pull, the sequence of the backward pass and forward pass, how to jumpstart a team of trade foremen to “get them to the wall” and how to pull in the General Contractor/Design Builder’s (“GC/DB”) leadership, resources, and commitment. But for now, let’s focus on the “magic” of getting a group of 10-20 trade foremen – each with his/her own personality, experience, attitudes and needs – actively to collaborate in the pull planning session.
Preparation
It starts with preparation – yours and theirs. Everyone involved
needs that “aha” moment when they realize that organized collaborative pull
planning kicks butt compared to the “lone genius” most projects using P6 have.
They’ve probably heard the statistics: 4-20 weeks saved on the schedule, doing 5
months worth of work in 3 months, doubling production in 6 weeks from $1.5
Million/Day to $3.0 Million/Day, and so on. However, it’s not real until you feel it.
We recommend the team spend 3-4 hours doing the Villego™ simulation. Until
you’ve experienced it yourself, you simply don’t understand the brilliance of
“pull”. For the session leader, it means preparing the materials to be used – post-

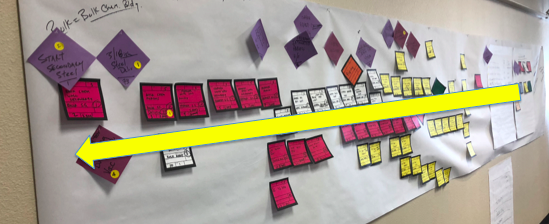

its, Sharpies, plotter paper, flip chart, painters tape, laminated site plans or floor
plans (elevations for skin), RFI logs, submittal logs, having the BIM model
running, etc. It also means pulling the leadership team together and selecting in
advance key milestones to be pulled with their target dates.
2. Enthusiasm
Once the session begins you must keep a steady and somewhat quickened/urgent pace to keep everyone’s attention and focus. The leader needs to be enthusiastic, both about the process and about the ability of each individual to contribute his/her unique skill, experience and knowledge to the team planning.
Set time expectations: “Ok, let’s get our tags up in 30 minutes, if you need help
I’ve got 2 hands.” Cheerlead: “Great job, Frank! Come on, Greg, get those 3 tags
up there before you write any more, the team needs your input on the wall.”
Broker conversations. Listen for what we call “the hum” that occurs as the
session hits its stride: the sound of multiple conversations about specific project
elements or approaches. It’s not too loud, not too soft, and sounds like a wavy
hum. Move around the room helping, encouraging, asking things like, “What else
has to be in place to release this work?” and then make sure tags keep moving to
the wall. Keep time, nudge, urge, “Ok we need to get to the next step, you’ve got
5 more minutes. You can do it!” Look, not everyone is that enthusiastic in real
life. We know that. But a pull plan session is a “stage” and the leader has to play
the part, so if you’re typically more reserved, think of it as an acting assignment.
Play the role. Step it up. Use your voice, your body, and your movements to keep
the planning focused and moving rapidly.
3. Neutrality
Why does the leader need to be neutral? Because the old paradigm of
construction (which is 85% of the projects the trades are on) is top down
command and control. There is no voice for “subs” and they aren’t allowed to say
“no”. They may be expecting to get steamrolled by the GC/DBer. The trades are
thinking: “Sure you want my input now, but in the end you’re going to tell us
what to do, and we had better do it.” However, to work effectively pull planning
needs a true collaborative team that trusts each other to tell it straight, give real
durations (no hidden float), and make reliable promises and keep them. To get
that kind of team spirit and collaboration, the leader must be neutral. It’s easy for
us coaches to be neutral. We work for what is best for the project, aka “Project
First”.
The leader needs to explain at the beginning of the session, “We want
your honest input today. Sure we’ve thought through this and have a plan for how
it could go, we wouldn’t have gotten this project without it. But that plan can
always be improved with your experience and your input. So we’re going to
figure this out together. And I’m going to stay neutral on what the better way to
build this is until we’ve talked through the options, gamed them with our tags, and
decided as a group what way will work to everyone’s advantage.” And as leader,
if you can’t resist and you need to step out of your neutral role and advocate for
one position, then hand the PEN to someone else to serve as the neutral leader for
a few minutes. When you’ve advocated for your position, announce you’re taking
the PEN back and now will be neutral again. If you do this, you will enhance
your leadership authority and build more trust from the team.
These are just a few of the insights we’ve learned from lots of experience with pull
planning. If you want more watch our recorded webinar, “How to Lead a Pull Plan Session” complete with photos, examples and plenty of tips.
Additional Resources:
1. How Lean Practices Represent the Future
2. Fauchier, Dan and Thais Alves, Last Planner is the Gateway to Lean Behaviors
(IGLC 2013, Fortaleza Brazil), http://iglc.net/Papers/Details/898
3. Umstot, David and Dan Fauchier, Lean Project Delivery: Building Championship
Project Teams, (2017, Amazon)
