Implementing the Last Planner Using Data Driven Model – New Zealand Case Study

Research and experience with the implementation of the Last Planner System (LPS) in the New Zealand (NZ) construction sector are very few. The NZ construction sector has had a very slow uptake on developing a lean culture and utilising lean tools such as the LPS. The main reason could be that the practitioners within industry are not connected together to share their experiences and collaborate within the local community and with Global Lean Practitioners.

However, since 2014 along with completing my PhD including a case study project in NZ, I have had the chance to study what are the industry requirements and how to support organisations to implement the LPS in a more efficient way. The results of the interviews and surveys (which have been partially presented in my previous research work) showed that more than 50% of the participants acknowledged that LP is not yet accepted or widespread in NZ industry. The results also indicate that the LP tool has not been fully implemented by more than 65% of the users.

The most common use of the LP tool is a Wall Plan and weekly meetings that brings the subcontractors and sometimes the other stakeholders together to develop the lookahead plan either using pull planning or only a common planning approach. While this had some benefits from a visual planning perspective and improve collaboration there is potential to add even greater value utilizing LP’s data.

When for the first time the Spreadsheet dashboard and LP metrics were introduced to a small group of users involved in my case project, the experience started changing as the data captured from the LP weekly meeting and daily check brought far greater insights to the project. This provided a more detailed insight in the processes across the project team particularly key stakeholders like the site managers/superintendent and the alliance board.

This approach known as a Data-Driven model (Figure 1) for the implementation of the LP is initially designed to track the PPC% (Percent Plan Complete), reasons for non-completion and monitor the productivity of different workstreams. The model was then introduced to wider work groups, not only in the case study project, but also across different types of construction works including buildings, housing, and commercial projects.

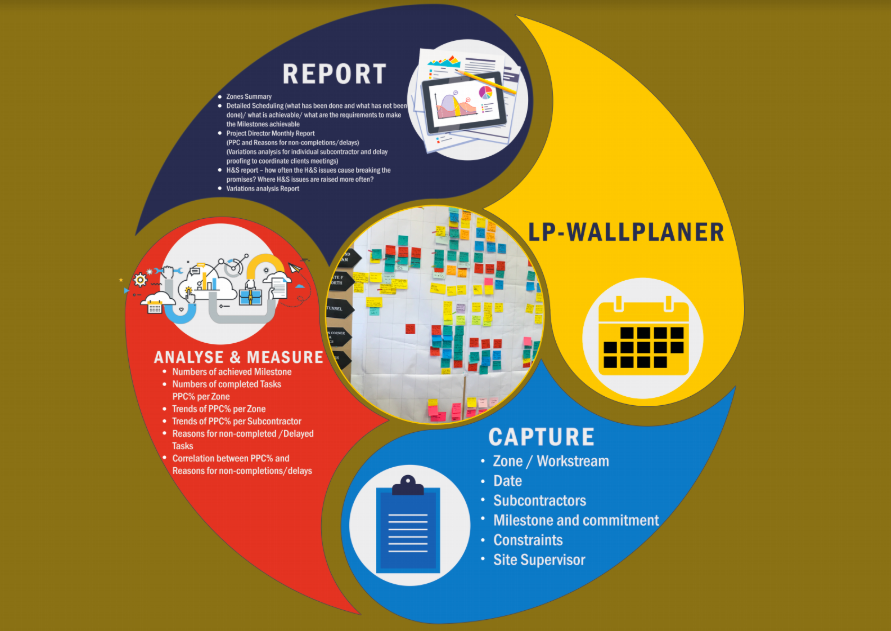

Figure 1. LP Data Driven Model

The LP dashboard was designed and used to present the trend of the progress across different work categories or zones for different resources including the project team and subcontractors that supported them with their decision making in different ways; e.g. resource management, control of the variations (reasons for non-completions/ constraints, unplanned events) and provided a reliable source of evidences for all parties that have been used for coordinating the client meeting, delay proofing, and relationship management.

Figure 2. LP Dashboard

This model has had its own challenges as it has been designed and run in Microsoft Excel using Visual Basic application. (see Implementation of the LPS using an excel spreadsheet: A case study from the New Zealand construction industry", Construction Innovation, Vol. 17 Issue: 3, pp.324-339, https://doi.org/10.1108/CI-01-2016-0002 ). The data-driven model successfully increased the level of detail on the many dependencies from different parts of the construction project. Another benefit I observed is that it leads to a change in culture within the projects by having more people wanting to attend the LPS session, reading the LP weekly reports, reviewing the level of contributions of different trades, identifying what and how constraints affect the achievement of the commitments, updating and developing a more reliable schedule and the many tasks. via access the LP dashboard (Figure 2). Practicing in this way and through the value delivered by the LPS enabled it to be more easily introduced to a wider range of audiences including the Project Director, Procurement, Logistics, Health & Safety, Project Resourcing (HR) and Sub-Contractors.

The value of the LPS went beyond the pull planning and operating as a Wall Plan. The LPS data captured and analyzed under this model also supported the projects to coordinate the client meetings, proofing their delays and making their resource utilization more efficient proactively avoiding delays.

This demonstrated the value of the LPS to allow Organizations and Projects within the New Zealand construction industry to develop transparent, auditable and data-driven decisions to deliver better outcomes to all involved. This empowers all stakeholders to make more informed decisions allowing effective management for on-time delivery thus avoiding unplanned delays and cost.

Featured Post

An Introduction to Set Based Design

Set-based Design (SBD) is a design methodology that has many applications in the architecture, engineering, and construction (AEC) industry. It was discovered when researcher studied the engineering and design process at Toyota [1]. Known as the “second Toyota paradox”, the researchers were surprised to find that Toyota considered a broader range of possible decisions, produced more physical models, delayed key decisions longer, and yet they had the fastest and most efficient vehicle development cycle in the industry.

Lean Design     Read more

How Lean Leaders are Changing the Construction Industry

As an engineering professional a few years into my career, I’ve focused on building my skills in a way that allows me to contribute positively to my clients, my company, and the construction industry. I quickly realized that becoming a student of Lean would allow me to do just that. Through opportunities at my company, Southland Industries, and my involvement with the Lean Construction Institute’s Lean Leader group, I’ve learned how Lean practices can transform a project, and how important engaging the next generation of professionals is to full industry transformation.

Lean Culture Read more

11 Scrum Steps to Get Twice the Work Done in Half the Time

Before I began my Lean journey in 2009, I honestly never thought about my capacity. I paused and reflected on what I had learned about applying Lean. My entry point was “Lean Thinking” by Womack and Jones, but even practicing the principles and some tools wasn’t increasing my management capacity beyond my first-year gains. I was a chronic workaholic and after beginning to practice Lean I was down to a consistent 55-60-hour workweek with only occasional Saturdays. Something was missing, I wasn’t improving. I had reached a plateau. I wasn’t satisfied.

Scrum Read more

Copyright © 2015- Lean Construction Blog
